Clackamas Water Environment Services has completed a project to improve the environmental functions of 3-Creeks Protected Area.
Three creeks — Mt. Scott, Phillips and Dean Creeks — converge on the site to form Mt. Scott Creek, making it an important location for surface and stormwater management and natural habitat. Mt. Scott Creek flows into Kellogg Creek and then to the Willamette River.
Urbanization is taking a toll on the site, with streams eroding, habitat changing and flooding of developed properties becoming more common. This project will enhance the floodplain, improve water quality, improve fish and wildlife habitat and provide opportunities for pedestrian access and environmental education on the site, where feasible.
3-CreeksProtected Area benefits our entire region.
3-Creeks Protected Area Floodplain Enhancement
Project Presentation - Dec. 2, 2021

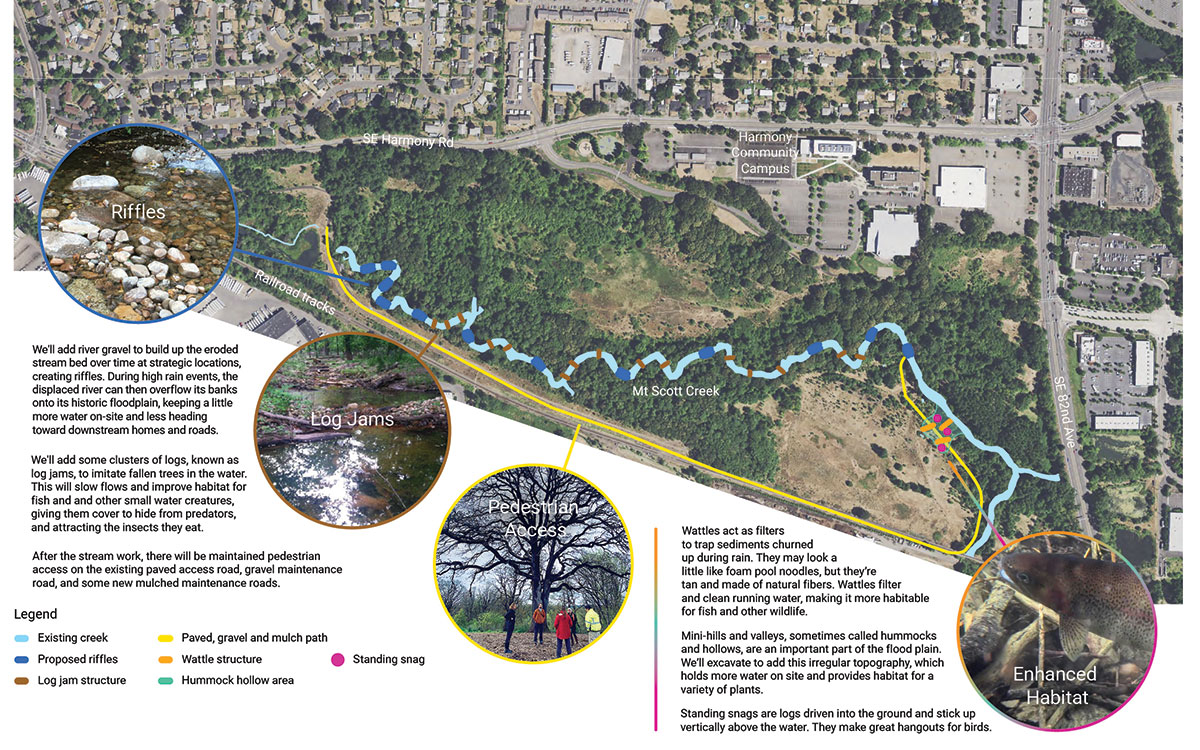

Aerial view of the 3-Creeks site showing the locations and examples of the planned riffles, log jams, pedestrian access, and hummocks and hollows
- Riffles: We added river cobble to build up the eroded stream bed over time at strategic locations, creating riffles. During high rain events, the displaced stream can then overflow its banks onto its historic floodplain, keeping more water on-site and less heading toward downstream homes and roads.
- Log Jams: We added clusters of logs, rootwads, and soil, called log jams, to imitate fallen trees in the water. This will slow flows and improve habitat for fish and and other small water creatures, giving them cover to hide from predators, and attracting the insects they eat.
- Pedestrian Access: Pedestrian access will be easier on the existing paved access road and a new mulched maintenance roads. This work is not yet complete.
- Floodplain grading: We have excavated to create more floodplain area from a previous upland area, to hold more water on site and provide habitat for a variety of plants. This work is not yet complete.
- Site restoration: The contractor will be restoring areas that were used for heavy equipment back to natural conditions by scarifying the soil and planting.
What’s new (Updated October 2026)
- In-water work was completed in late September. In all, we constructed 7 riffles, 3 cascades, 12 log jams, and X post reinforcement structures. We also created new floodplain area through excavation (in process-not yet complete).
- Work still to be completed includes restoring areas used for equipment access and planting, which starts later this fall, and the remainder of excavation in the floodplain grading area.
- Once water was reintroduced to the stream, we could already see it backing up and spreading out behind the constructed habitat features. It is looking like we will meet our goal of keeping more water on site during big storms!
What we’ve completed so far
- Contractor partially completed the floodplain grading area, to create more floodwater storage and wetland habitat. An archaeologist monitored the excavation.
- Prior to construction, we held walking tours, volunteer amphibian egg mass surveys, and a bioblitz on site.
- Signs were posted and flyers distributed to warn people that the site is closed during construction.
- No public access was allowed during construction, for safety.
- Contractor constructed an access route, including tree removals, to allow access to the work areas.

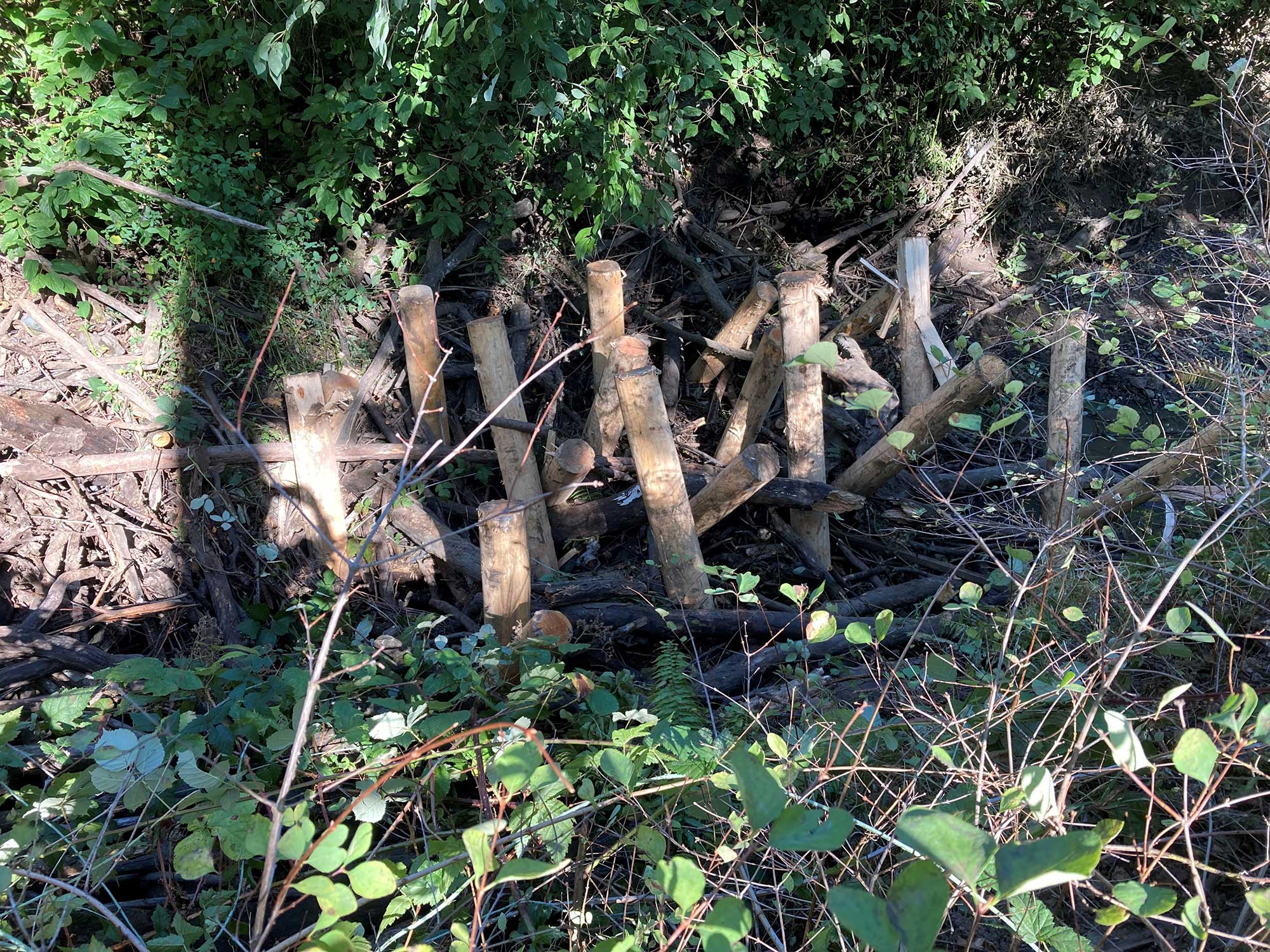

- Contractor began in-water work in summer 2025, completing the first set of post reinforcement structures.
- North Clackamas Watersheds Council and Unite Oregon held several walking tours, including a birdwatching tour for the community
- Developed materials and posted signage to make people aware of our schedule and warn about the danger of accessing the site during construction.
- Developed 30%, 60%, 90%, and100% plans, specifications and cost estimate
- Received final permits/approval from Oregon Dept. of State Lands (DSL), Oregon State Historic Preservation Office (SHPO), US Army Corps of Engineers (USACE), National Marine Fisheries Service, Oregon Dept. of Fish & Wildlife-Fish (ODFW) Passage Coordinator, and Clackamas County Planning (floodplain devel permit).
- Partner North Clackamas Watersheds Council has completed online meetings and site tours with Unite Oregon and community members. Their work included outreach to underserved communities.
- Conducted on-site surveys, site assessment
- Alternatives development and analysis, including Hydraulic & Hydrologic modeling Public outreach, stakeholder meetings, and public input
- We were selected for a Metro Nature in Neighborhoods Capital Grant and have a grant agreement in place.
- Completed a Cultural Resources Assessment and shovel probe survey, and historic evaluation of the existing bridge. The shovel probe surveys turned up 16 pieces of lithic debris, considered pre-contact fragments leftover from tool-making. The bridge was determined not eligible for listing in the National Register.
- The Wetlands Conservancy has conducted two years of volunteer amphibian egg mass surveys. The survey found egg masses from the Pacific chorus frog, 24 long-toed salamander, northwestern salamander, and red-legged frog. This is a sign of very good habitat quality in the existing wetlands!
- Bidding was completed and WES hired a contractor to construct the restoration project.
News about the 3-Creeks Protected Area Floodplain Enhancement Project
Clackamas Water Environment Services (WES) celebrated the groundbreaking of the 3-Creeks Protected Area Floodplain Enhancement Project with county officials and our amazing partners.
