Transportation Maintenance

Transportation Maintenance

Road System Overview

Statistics on Clackamas County's Road System.

Road Conditions 2019

Road Condition By Miles

Condition 2019
Very Good 976
Good 272
Poor 101
Very poor 58
Total 1407*

*The remaining 6 miles are gravel

County Road System: 1,413 Miles

331 Urban Road Miles
1,076 Rural Road Miles

Maintenance Responsibilities

  • 700 miles of striping
  • 180 bridges
  • More than 2,400 miles of gravel shoulder
  • More than 27,100 traffic signs
  • 1,885 manholes
  • 9,330 catch basins
  • 8,130 culverts and storm sewers
  • 110,760 feet of guardrail
  • 250 miles of mechanical brushing
  • 2,500 curb miles of street sweeping
New Format?
On

Adopt-A-Road Volunteer Agreement

Your safety is our first priority. To participate in the Adopt-A-Road program, you must agree to the terms below.

Adopt-A-Road volunteers agree to:

  • Complete and submit an application form.
  • Pick up litter on the segment of road described in the application.
  • Pick up litter on the adopted roadway segment at least twice a year during daylight hours.
  • Select clean up dates at least 1 week in advance after organizing with Adopt-A-Road Program Coordinator.
  • Limit your work to the area between the edge of the traveled portion of the road and the outer shoulder of the right-of-way boundary.
    • Do not pick up litter or perform any landscape activities in the road median unless specifically advised to do so by the county.
    • Do not perform any work in the traveled portion of any road.
  • Place all litter in trash bags, and leave the trash bags and any bulky items along the shoulder or in the ditch away from the traveled portion of the roadway.
  • Conduct safety training and review safe work practices with all participants before each work session. The Adopt-A-Road Program Coordinator will review safety information with your volunteer lead prior to clean up date.
  • Install temporary traffic warning signs and devices as specified in the permit before each work session.
  • Get a signed liability release form from every participant before each clean-up event.
  • Provide adequate adult supervision for all participants between 12 and 18 years of age.
    • No one under 12 will be allowed on site.
    • A signed liability release form from the guardian or parent of those between the ages of 12 and 18 is required.
  • Pick up and return equipment or supplies borrowed from the county during regular business hours within 1 week of their use.
  • Leave any hypodermic needles or material(s) that may be hazardous, too large or too heavy to be safely moved by hand, and report the location of those materials to the county.

The Department of Transportation and Development agrees to:

  • Help you identify a suitable road to adopt.
  • Inspect all requested road segments for safety, including sight distance, vehicle speeds, traffic volumes and adequate shoulder width.  We retain the right to deny any location for adoption because of safety concerns.
  • Provide OSHA-approved high visibility vests, temporary traffic safety signs, safety training material, trash bags and other devices as needed, with instructions for their use.
  • Remove and dispose of filled trash bags from the adopted road.
  • Arrange for removal of large heavy material, hypodermic needles or hazardous material from the adopted road.
  • Make and post a sign recognizing your clean-up efforts. (Roadway signs are only posted for groups that agree to volunteer to pick up litter at least twice a year for a minimum of 2 years.

Contact us

For questions, contact Ron Buck, Adopt-A-Road Program Coordinator, at
AdoptaRoad@clackamas.us or 503-650-3347.

New Format?
On

Winter Weather Response

When Transportation Maintenance receives a winter storm forecast, we divide our workforce into 2, 12-hour shifts to provide 24-hour coverage on the county road network. Our approach is to get ahead of weather events to provide the safest conditions possible for those traveling in Clackamas County.

Road maintenance priorities in winter weather

With more than 1,400 miles of county roads covering nearly 1,900 square miles, we have prioritized which roadways we attend to first, based on safety and meeting the needs of the largest number of people. As always, providing access for emergency vehicles is a top priority.

County roads are treated, plowed and sanded in the following order:

High Major transportation routes with moderate to high traffic volumes and major collector routes (roads that collect traffic from neighborhoods) with moderate traffic volumes and steep roads serving residential areas.
Major route examples: Beavercreek Road and Sunnybrook Boulevard.
Medium Minor collector routes, urban residential roads, and rural local roads that carry moderate to low traffic volumes. These are plowed during regularly-scheduled work hours when staff and equipment are available.
Low Urban residential cul-de-sacs and rural local roads with low traffic volumes are plowed during regularly-scheduled work hours depending on staff and equipment availability. Due to the size of the county, it is rare that road crews make it to low priority streets.

Once the severe weather is over, recovery may take even longer than the initial response. For example, sand applied during a 3-day snowstorm can take up to 3 weeks to remove. Therefore, we try to minimize the use of sand and use anti-icing material instead where possible.

Winter weather preparation and operations

Stockpiling
Storing necessary equipment and materials in anticipation of weather events allows us to be more effective and efficient. We have 18 sites throughout the county so trucks, equipment, and stockpiles of sand and magnesium chloride are ready when we need them.

Ice prevention
An application of chemicals that slows the formation of ice and prevents ice from sticking to the pavement. A solution of magnesium chloride can only be applied to the pavement when conditions are dry and the temperature is no higher than 40 degrees and falling. You may notice trucks spraying liquid in a series of lines that run along the road prior to freezing temperatures setting in, this is the ice prevention application.

Snow plowing
When snow accumulation has reached 2 inches and is continuing to fall, we will be on the roads plowing. We also plow bikeways that are directly connected to major roadways, but not bicycle lanes that are separated from the roadway by a barrier.

Snow/Ice removal
Snow plows clear the roadways and spread a mixture of sand and/or chemicals on top of the cleared snow pack or ice. When this layer softens after the treatment, then another pass of a snow plow will remove the next layer from the road surface to improve traction.

Clean-up
We sweep up sand from roads and on-street bicycle lanes after a winter storm to increase the safety of the roadway and protect environmental quality by keeping the sand and other de-icing materials out of the drainage system. Depending on the severity of the storm, clean-up can take several weeks.

How the public can help

If at all possible, don't abandon your vehicle on the roadway
Vehicles abandoned in the right-of-way create unsafe travel conditions for everyone else. Abandoned vehicles impact drivers' line of sight and block snowplows, emergency vehicles and public transit. If you abandon your vehicle in the right-of-way, you will be responsible for the towing expenses, as well as any damage caused from being an obstruction on the road.

Clear sidewalks, driveways and mailboxes
Property owners are responsible for removing snow from sidewalks in front of their property, and for clearing access to their driveway and mailbox. Please do not move snow onto the public roadway as you clear sidewalks and driveways, as this can create a hazard for travelers.

Increase your traction
You can equip your vehicle with better traction by using traction tires, snow chains or studded tires in winter weather. Practice putting snow chains or cables on your tires before the snow comes. Watch a video from ODOT showing how to install cable chains. If you use studded tires, note that they are allowed in Oregon from Nov. 1 to March 31.

Drive responsibly and be prepared
If staying home isn't an option during a winter weather event, you can plan ahead by giving yourself plenty of time to get to your destination, allowing for extra stopping distance and keeping tools in your car such as an ice scraper, car jack, jumper cables and road flares. Also bring water, food and blankets in your car if you have to venture out during a winter storm. You can use TripCheck to find road and weather conditions to be informed before you leave.

Contact us

If you have a concern about an unsafe roadway, please contact:

  • Transportation Maintenance, 503-557-6391, during regular business hours (Monday through Thursday, 7 a.m. to 5:30 p.m.) or during ongoing snowplowing operations. You can also report road concerns online or by email at RoadConcerns@clackamas.us.
  • Sheriff/C-COM non-emergency number, 503-655-8211, after hours and during weekends and holidays.
New Format?
On

The Canby Ferry - M.J. Lee II

Your good-natured commute since 1914

Canby Ferry is a car and walk-on ferry that transports people across the Willamette River between Canby and Wilsonville. Every day, the choice is yours: grind out the same old bumper-to-bumper commute, or sit back and relax as you float across the Willamette for a few minutes of peaceful nature.

  • From Wilsonville, the north side, you can get on the ferry from Southwest Mountain Road
  • From Canby, the south side, you'll get on the ferry by taking North Holly Street
  • The ride takes about five minutes to get across.
  • The ferry does not have a set schedule; ferry conductors travel on an as-needed basis.

Ferry Hours and Status

The Canby ferry will have a late opening on April 29 due to maintenance, we will be opening at 12 p.m.

open

The ferry is open daily from 9 a.m. to 6 p.m., except on holidays* and when the river level is at 70 feet or higher.

*Holidays include New Year's Day, Martin Luther King Day, Presidents Day, Veterans Day, Thanksgiving Day and Christmas Day.

Call the Canby Ferry Information Line for status updates at 503-650-3030.

Fares

Motorcycles, bicycles, pedestrians$3
Cars and pickups
(Up to 22 feet long)
5
Vehicles with trailers
(Over 22 feet long)
10
Vehicle using entire lane15
Vehicle using entire ferry30
Punch card (20 crossings)
(Save $1 per crossing)
80

All fares are one-way. No debit or credit cards are accepted at the ferry; only cash or checks. Punch cards may be purchased online using a debit or credit card.

Subscribe to get Canby Ferry updates

Ferry History, Technical Specifications and Feasibility Study

37851
New Format?
On

Road Restoration

Step 1 Analyze the condition of the roadways every year, on-site, with a computerized pavement management system.
Step 2

Combine the data gathered from the annual analysis with other information about each roadway, including:

  • road classification
  • road surface type
  • the average cost to restore the road to its proper functioning condition
  • road history
Step 3
Create a prioritized list of roadway repair and maintenance projects based on the most cost-effective timing of repairs.
Step 4 Develop preliminary cost estimates for each likely project based on historic costs per lane mile.
Step 5 Compare the preliminary cost estimates with estimated budget amounts and group the projects into a five-year plan.
Step 6

Compare and, as needed, revise the five-year plan with project lists from other agencies and organizations that may need to work on the roadway, including the County Development Agency, County Water Environment Services and other utility providers.

This saves money, time and inconvenience to the public by reducing how often work is needed on a particular roadway.

Step 7 Group the final list of road projects into contract packages.

A multi-phase construction process is used to do the actual road restoration.

  • First, during the winter and spring County crews repair the roadway's drainage and road base. This may include reconstruction of drainage and ditch systems, repair of failed road base sections and preparation for any other work such as improving a shoulder.
  • During the summer, contractors place asphalt on the roadway and rock on the shoulders, and stripe the roadway.

The result is:

  • a safe roadway
  • with rock or paved shoulders
  • that drains properly and
  • has a life expectancy of 15-20 years with regularly scheduled maintenance*.

*Over time, oil in asphalt oxidizes and becomes brittle. County crews typically apply a chip seal to the roadway 7-10 years after the paving is completed to seal any small cracks that may be forming and restore a flexible surface to the roadway. This may be done two or three times during the life of the pavement.

New Format?
On

Road Maintenance Projects

Routine Maintenance

Our maintenance team provides a variety of services year-round to keep our 1,400 miles of county roads safe, reliable and easy to navigate.

110951

Bridge Maintenance

Our 186 bridges are inspected every 2 years and through those inspections we sometimes find repair and maintenance work that needs to be done to preserve the bridge structure and keep it safe for travelers. That work often includes bridge scour projects, either removing excess soil from stream channels or replacing soil around foundations that has been washed away during high water events.

32806
Contact for Bridge Maintenance
Department Staff
Kevin Morris
Transportation Maintenance Supervisor
503-650-3246

Pavement Rehabilitation

Pavement rehabilitation includes treatments that extend the life of an existing road surface such as surface sealants, patching short spans of roadway and asphalt paving. These proactive measures add structure to the road, remedy pavement distresses, and maintain a road's condition to defer full reconstruction further in the future. See schedule for next five years.

Scheduled pavement rehabilitation projects in unincorporated Clackamas County (schedule could change):

2024 paving projects

Canby area: 2 miles

  • Haines Road: Hwy 99E to Mulino Road
  • Territorial Road: Haines Road to Hwy 99E

Milwaukie Area: 1 mile

  • Overland St: Bell Ave to 82nd Ave

Redland area: 2 miles

  • Fischers Mill Road: Fischers Mill Bridge to Springwater Road
  • Harding Road: Springwater Road to Fischers Mill Road
  • Strowbridge Road: Springwater Road to Fischers Mill Road

Our crews will also repair short spans of roadway throughout the county, including:

  • digging out and repaving rough pavement
  • sealing cracks
  • repairing slides
32866

Paving Projects Planned Five Years in Advance

Learn more about our 5-year pavement management plan.

Contact for Pavement Rehabilitation
Department Staff
Paving Hotline
503-650-3744

Pavement Preservation

To extend the life of a road, surface treatments are applied the existing roadways throughout the county including slurry seal and chip seal. A slurry seal is a coating of liquid asphalt; a chip seal is a coating of liquid asphalt and rock chips. See schedule for next five years.

Scheduled pavement preservation projects in unincorporated Clackamas County (timing could change):

2024 slurry seal project

Timeline: Expect crews to work Monday – Friday between 7 a.m. and 6 p.m. for 2-3 weeks between July and mid-September. Watch for
signs to be posted approximately 2 weeks before work begins.

Traffic impact: All roads will remain open, but expect lane closures and traffic delays up to 20 minutes. Flaggers will direct all travelers.

Vegetation note: If you live within one of the road segments set to be sealed, please trim your bushes and trees within one foot of the curb nearest your property

Jennings Lodge area slurry seal map

Jennings Lodge area: 6 miles

This project will place slurry seal on 6 miles of the following urban roads:

  • Abernethy Lane: Highway 99E @ guardrail to Glen Echo Ave
  • Addie St: Boardman Ave to Glen Echo Ave
  • Babbler St: Jennings Ave to dead end
  • Blanton St: Boardman Ave to 18687 Blanton St
  • Britton Ave: River Road to Kay St
  • Cottonwood St: dead end to 4277 Cottonwood St
  • Gill St: Abernethy Lane to Woodcock Ave
  • Glen Echo Ave: River Road to 4400 Glen Echo Ave
  • Hull Ave: Highway 99E to Portland Ave
  • Hull Ave: Highway 99E to River Road
  • Jennings Ave: River Road to Willamette Dr
  • Jewett Dr: Jennings Ave to dead end
  • Kay St: Glen Echo Ave to Rinearson Road
  • La Cour Ct: Glen Echo Ave to dead end
  • Marcia Court: Glen Echo Ave to dead end
  • Meldrum Ave: Abernethy Lane to Cottonwood St
  • Meyers Ave: Addie St to Abernethy Lane
  • Mildred St: Highway 99 to Glen Echo Ave
  • Old Orchard Court: Glen Echo Ave to dead end
  • Portland Ave: Hull Ave to Caldwell Ave
  • Rinearson Road: River Road to 5051 Rinearson Road
  • River Dr: River Road to dead end
  • River Drive Ct: River Dr to 19304 River Drive Ct

2024 chip seal project

Timeline: Expect crews to work Monday – Friday between 7 a.m. and 6 p.m. for 2-3 weeks between July and mid-September. Watch for signs to be posted approximately 2 weeks before work begins.

Traffic impact: All roads will remain open, but expect lane closures and traffic delays up to 20 minutes. Flaggers will direct all travelers.

Vegetation note: If you live within one of the road segments set to be sealed, please trim your bushes and trees within one foot of the curb nearest your property

Redland area chip seal map

Redland area: 46 miles

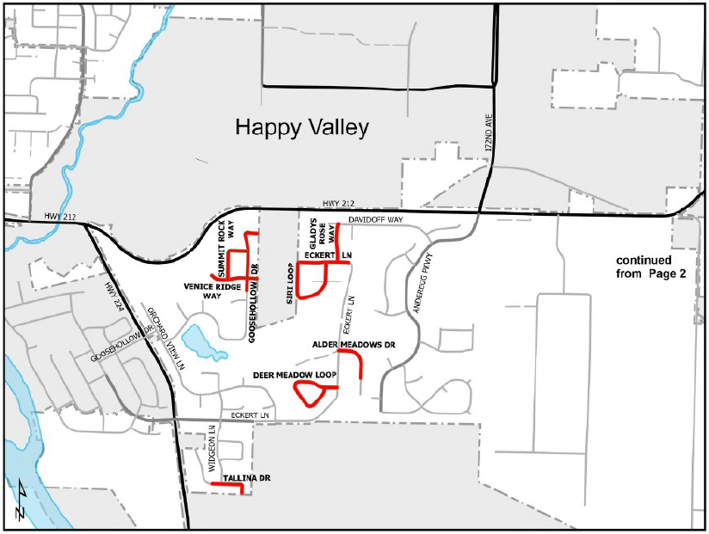

This project will place 46 miles of chip seal on the following rural roads:

  • Archer Dr: Outlook Dr to culdesac
  • Arnett Dr: Fischers Mill Road to culdesac
  • Arrowhead Dr: Archer Dr to 16403 Arrowhead Dr
  • Badger Dr: Polehn Dr to Indigo Road
  • Bogynski Road: Henrici Road to 18011 Bogynski Road
  • Bradley Road: Redland Road to 14950 Bradley Road
  • Cadle Road: Glisan Road to 18405 Cadle Road
  • Canter Ln: Redland Road to 17640 Canter Ln
  • Carlson Road: Forsythe Road to 17420 Carlson Road
  • Clear Acres Dr: Hattan Road to Gunzer Dr
  • Cliffview Road: Forsythe Road to Victory Road
  • Creek Road: Henrici Road to 19416 Creek Road
  • Criswell Road: Springwater Road to 20195 Criswell Road
  • Curtis Court: Forsythe Road to culdesac
  • Danny Court: Henrici Road to culdesac
  • Deininger Road: Fischers Mill Road to 17620 Deininger Road
  • Dick Dr: Dick Dr to 17601 Dick Dr
  • Dick Dr: Hattan Road to 17921 Dick Dr
  • Dillman Road: Henrici Road to 18400 Dillman Road
  • Edgewood Ln: Edgewood St to culdesac
  • Edgewood St: Hattan Road to culdesac
  • Elida Road: Redland Road to Glisan Road
  • Fawn Dr: Archer Dr to culdesac
  • Fieldstone Ln: Redland Road to dead end (MP 062)
  • Fischers Mill Road: Redland Road to Strowbridge Road
  • Forest Hill Dr: Sprague Road to Pear Road
  • Forsythe Road: Bradley Road to Cliffview Road
  • Glisian Road: Elida Road to Norman Road
  • Grasle Road: Redland to North End Road
  • Hattan Road: Springwater Road to Fischers Mills Road
  • Henrici Road: Beavercreek Road to Redland Road
  • Hilltop Road: Bradley Road to 15987 Hilltop Road
  • Hinkle Road: 18845 Hinkle Road to Redland Road
  • Holcomb Blvd: Edenwild Ln to Bradley Road
  • Jasan Dr: Henrici Road to dead end
  • Jean Dr: Fieldstone Ln to dead end (MP 019)
  • Kimball Road: Fischers Mill Road to 18820 Kimball Road
  • Lucky Ln: Dick Dr to culdesac
  • McCubbin Road: 23029 McCubbin Road to 23139 McCubbin Road
  • McCubbin Road: Springwater Road to 17225 McCubbin Road
  • Meadow Ave: Henrici Road to dead end
  • Morel Dr: Pam Dr to 15401 Morel Dr
  • Norman Road: Redland Road to culdesac
  • North End Road: Grasle Road to Terry Michael Dr
  • Outlook Road: Bradley Road to 16696 Outlook Road
  • Outlook Road: Bradley Road to Sky Ranch Ln
  • Overlook Road: Forsythe Road to Hoffman Road
  • Pam Dr: Holcomb Road to culdesac
  • Pear Road: Polehn Dr to Forest Hill Dr
  • Polehn Dr: Redland Road to Badger Dr
  • Potter Road: Redland Road to Bradley Road
  • Redland Road: Ridge Road to Abernethy Road
  • Redland School Road: Hattan Road to gate at MP 040
  • Ridge Road: Fischers Mill Road to Redland Road
  • Sky Ranch Ln: Outlook Road to 15406 Sky Ranch Ln
  • Stoltz Road: Holcomb Blvd to 16170 Stoltz Road
  • Sunset Ave: Babbler St to Blanton St
  • Terry Michael Dr: North End Road to 18538 Terry Michael Dr
  • Trail Ridge Road: Bradley Road to culdesac
  • Victory Road: Cliffview Road to Forsythe Road
  • Wachtman Road: Bradley Road to 16829 Wachtman Road
  • Wildflower Ln: Pam Dr to culdesac
  • Wilmot St: Jennings Ave to dead end

2024 curb ramp and cape seal project

Timeline: Expect crews to work Monday – Friday between 7 a.m. and 6 p.m. for 2-3 weeks between mid-March and May.

Traffic impact: We plan to keep all roads open to local traffic, but there may be lane closures and occasional traffic delays of up to 20 minutes at a time. Flaggers will direct all travelers during construction hours if necessary. Local detours may be needed.

Vegetation note: If you live within one of the road segments set to be sealed, please trim your bushes and trees within one foot of the curb nearest your property

Lake Oswego/Southwood Park area: 2 miles

Constructing ADA-compliant curb ramps at:

  • 61st Ave/Southwood Dr intersection
  • 62nd Ave/63rd Ave intersection
  • 62nd Ave/Southwood Dr intersection
  • 63rd Ave and 63rd Place intersection
  • 63rd Ave and Douglas Dr intersection
  • 63rd Ave and Southwood Dr intersection
  • 63rd Ave from 64th Ave intersection
  • 64th Ave near 13179/13190

This project will also place 2 miles of cape seal on the following urban roads in the Southwood Park area:

  • 61st Ave: 62nd Ave to Southwood Dr
  • 61st Ave: 61st Ave to dead end
  • 61st Ave: 62nd Ave to Pamela St
  • 62nd Ave 63rd Ave to Pamela St
  • 63rd Pl: 62nd Ave to Southwood Dr
  • 63rd Pl: 63rd Ave to dead end
  • 64th Ave: Douglas Dr to 63rd Ave
  • 64th Ave: Pamela St to Southwood Dr
  • Douglas Dr: 63rd Ave to 64th Ave
  • Pamela St: 61st Ave to 61st Ave
  • Southwood Dr: 64th Ave to 61st Ave

Chip Seal FAQ

30991
Contact for Pavement Preservation
Department Staff
Daryn Thorpe
Transportation Maint Tech, Sr.
503-722-6301
New Format?
On
